Automatic scheduling of materials in MS Project Pro
Contents:
- Automatic scheduling of material resources in the Gantt chart view in MS Project Pro
- Automatic scheduling of material resources in the task usage view in MS Project Pro
- Automatic scheduling of material resources in the resource usage view in MS Project Pro
- Chat

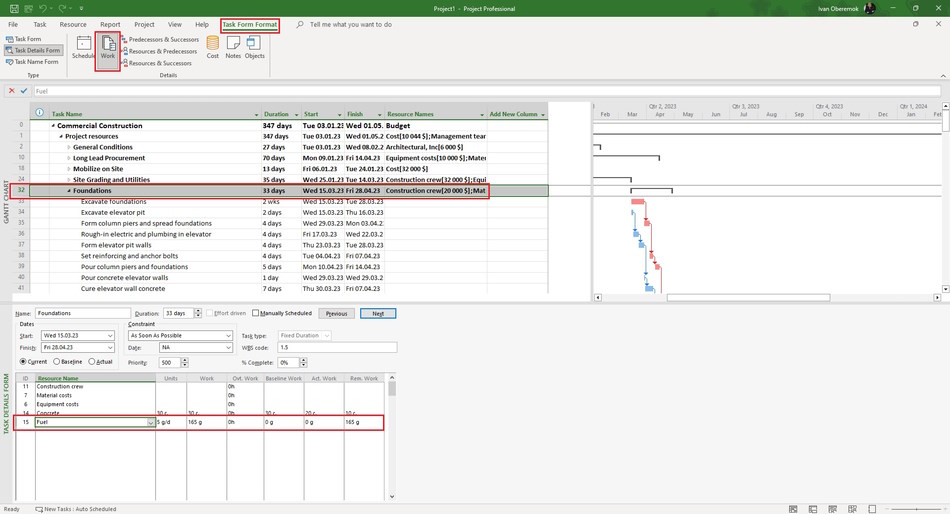

Automatic scheduling of material resources in the Gantt chart view in MS Project Pro
With automatic materials scheduling, you link the duration of the task and the amount of the material's payments. This, as the duration changes, the material''s costs change.
Steps to assigne equipments resources for automatic scheduling in MS Project Pro:
- Open the Gantt chart view.
- Click the "Task" item in the top menu.
- Click the "Details" item in block "Properties".
- Click the "Task Form Format" item in top menu for window "Task details from".
- Click the "Work" item in block "Details"
- Choose resources in the window "Task details from" in the "Resource Name" field.
- Enter units for each assigning material resources for period in the 'Units" field. You can specify the cost for periods: hour - "hr", day - "d", week - "wk", month - "mo", year - "yr"
- Click the "OK" button.

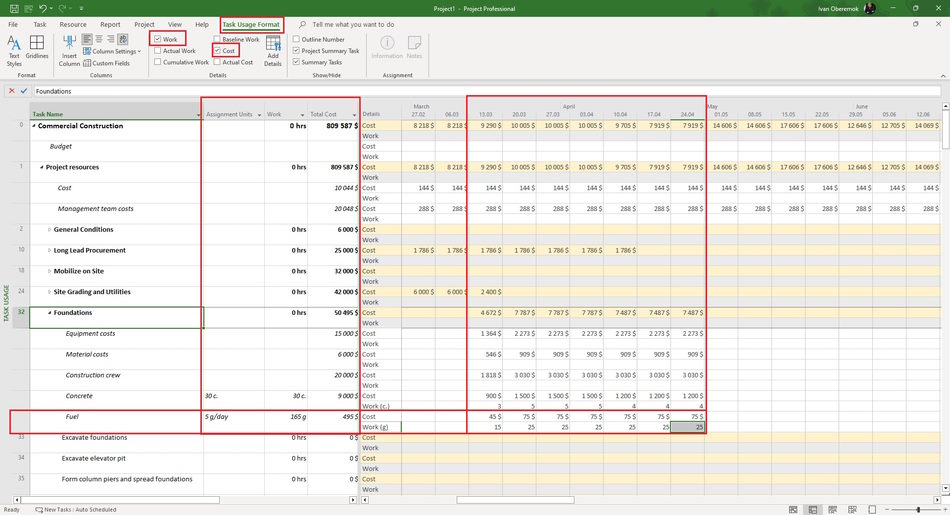

Automatic scheduling of material resources in the task usage view in MS Project Pro
Steps to assigne material resources for automatic scheduling in MS Project Pro:
- Open the "Task Usage" view.
- Add columns: "Assignment Units", "Work", "Total Cost", and "Resource Names".
- Assign material resources to tasks in the ""Resource Names"" column.
- Edit the material resource cost for period in the "Assignment Units" column. You can specify the cost for periods: hour - "hr", day - "d", week - "wk", month - "mo", year - "yr"
- The system will calculate the costs in columns: "Total Cost" and "Work".
- Click the "Task Usage Format" item in the top menu.
- Click the boxs: "Cost" and "Wok".
- Set the monthly time period. (Read more "Timescale in MS Project Pro")
- Refine task cost distribution by time period in the "Work" field on the right part.

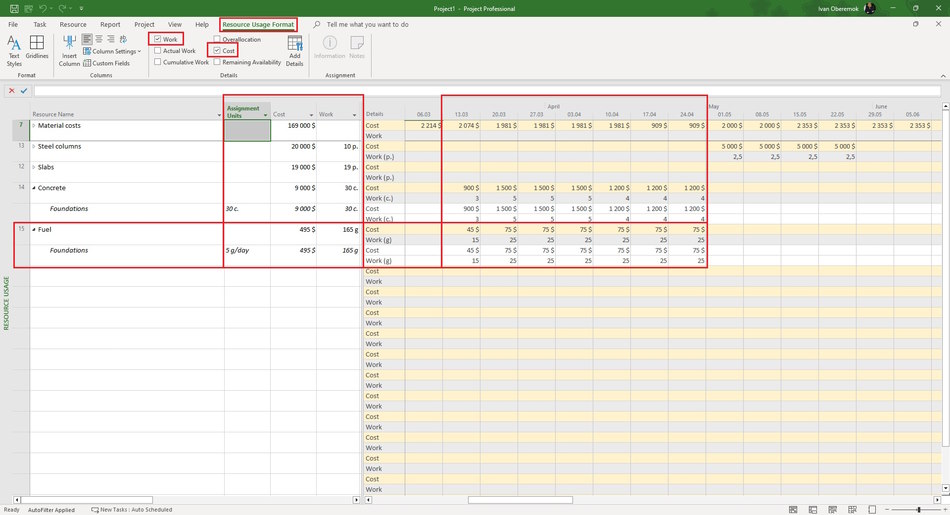

Automatic scheduling of material resources in the resource usage view in MS Project Pro
Steps to assigne material resources for automatic scheduling in MS Project Pro:
- Open the task usage view.
- Add columns: "Work", "Total Cost"
- Assign material resources to tasks in the ""Resource Names"" column.
- Edit the material resource cost for period in the "Assignment Units" column. You can specify the cost for periods: hour - "hr", day - "d", week - "wk", month - "mo", year - "yr"
- The system will calculate the costs in columns: "Total Cost" and "Work".
- Click the "Task Usage Format" item in the top menu.
- Click the boxs: "Cost" and "Wok".
- Set the monthly time period. (Read more "Timescale in MS Project Pro")
- Refine task cost distribution by time period in the "Work" field on the right part.

#msprojectpro, #oberemokii, #projectmanagment, #projectresourcemanagement, #planningprocess
