Creating a budget and work report in MS Project Pro
Contents:
Creating a budget and work report report in MS Project Pro
To analyze the load of specialists of a company or department, you can create a report in MS Project Pro. In the report, we compare the budget work and work of the project by period.

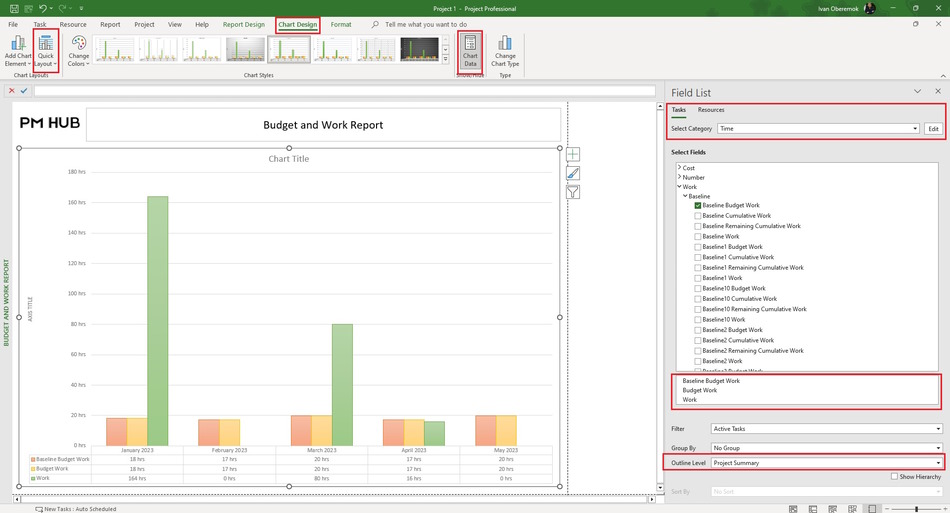

Steps to add a chart to a budget and work report in MS Project Pro:
- Click the "Report" item in the top menu.
- Create the report.
- Click the "Report Design" item in the top menu.
- Click the "Chart" button in the "Insert" block.
- Set the report name.

Steps to customize the chart data:
- Click the "Chart Desigen" item in the top menu.
- Click the "Chart Date" button in the "Show/Hide" group.
- Select the "Tasks" in the "Field List" block.
- Select the "Time" in the "Select Category" field.
- Click the "Edit" buttom. Set the time period format:
- Set the "Querters" in the "Units:" field.
- Set period start date in the "Start:" field.
- Set period end date in the "Finish:" field.
- Click the "Ok" button.
- Click on the required fields in the "Select Field" box. Select fields: "Basline Budget Work", "Budget Work" and "Work"
- Select the "All Tasks" filter in the "Filter" field.
- Set the outline level in the "Outline Level" field.
For customize the chart in the report in MS Project Pro select the chart: (Read more "Customize the chart in the report in MS Project Pro")
Block "Chart Layouts"
- Add Chart Element - You can add chart elements: "Axes", "Axes Title", "Chart Title", "Date Label", "Date Table", "Error Bar", "Gridlines", "Legend", "Lines", "Trendline", "Up/Down Bar". The list of elements depends on the type of chart
- Quick Layout - You can use templates with set elements.
Block "Chart Style"
- Change Colors. You can choose a set of color templates click the "Change Colors" button and choose the color template.
- Select a chart style, click the "Chart Style" block.
Block "Change Chart Type"
- You can change the chart type. Click the "Change Chart Type" button and select the chart type.
